AvailAgility
Karl Scotland – Using Agile to Deliver Value
Karl Scotland – Using Agile to Deliver Value
Oct 28th
After over a year of blogging, I finally decided that it was time to move off wordpress.com and invest in an independently hosted version that gave me some more flexibility. So today I bit the bullet and grabbed availagility.co.uk (availagility.wordpress.com is being redirected, so all the old links should work). If you see anything which looks odd, or find any links which don’t work, please let me know.
I should also give credit to Just Host, who provided a seamless process for setting everything up, including a very quick and helpful response to a support request when figuring out how to get the redirects working.
Update: One of the downsides to moving the blog that I lost all of the article ratings. Feel free to go through and re-rate any entries you feel deserve it!
Oct 21st
David Harvey posted a brilliant piece on his blog entitled “The Scrum Picture is Wrong”. I highly recommend reading it. His ideas and suggestions for an alternative Scrum picture got me thinking about how to visualise Lean and Agile software development in a process or label agnostic way. David’s picture looked like a figure of eight, and there seemed to be 2 inputs (a vision and reality), and 2 outputs (the product and the team). A quick google found me what I was looking for here – a figure of eight with a bar across the top and bottom. “A time sign that according to Diderot’s Encyclopedia meant hour for the chemists in eighteenth century France”. That seems quite appropriate. An hour would be quite a good interval for a feedback loop

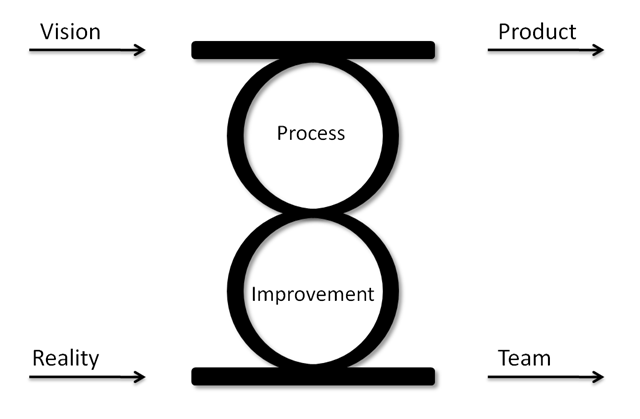

This is what I came up with. A vision and reality come together to produce a product and a team through process and improvement (and process improvement)
Now I just need to find a good label to stick on it…
Oct 20th
Firstly, this post is not an attempt to be divisive or competitive. Instead it is meant to be exploratory. What would it mean for the statement in the title to be true? Actually, the full statement was “People have so misunderstood Scrum, that they’ve reinvented it and called it Kanban”. It was made by Jim Coplien at Scan-Agile, after (but not necessarily the result of) a conversation over dinner where myself and a few others were describing how we used Kanban. Each time we described different aspects of our processes, Jim would say something along the lines of “but I do that with Scrum”.
So what would it mean for people to have so misunderstood Scrum that they have reinvented it and called it Kanban?
These are just some of my thoughts. They do not mean that I think Scrum is bad – just not perfect. They do not mean that I think Kanban is perfect – although it’s currently my first language. The topic drew a good crowd at the Scan-Agile Open Space and we had a good discussion. What else might it mean?
Oct 12th
I’ll be talking about 5 Steps to Kanban at Software East on November 19th. From the website:
This event will take place at Red Gate Software, Newnham House, Cambridge Business Park. See the location map for Red Gate Software.
BOOK NOW for this event. Tickets (including light buffet) £15 if booked on or before 16th November, £25 thereafter. Places strictly limited.
Oct 9th
Mary Poppendieck gave a talk on Workflow is Orthogonal to Schedule at Agile2009, during which she very neatly transitioned a schedule-focused view of work, into a flow-focussed view. At least I thought it was neat, so I’m going to try and reproduce the basic elements here, using my favourite agile workflow.
Here we have a schedule showing an average of 4 features being delivered every 4 week time-box. Each time-box is preceded by 2 weeks understanding the next features, and a release is made every 8 weeks. Its not a bad schedule. There’s a regular release every two months which is better than a lot of projects, but it could be better.
Now we reduced the time-box to 2 weeks, meaning that we do an average of 2 features in each time-box. This means that the preparation now takes only 1 week. Additionally, we are now releasing at the end of every time-box, which is also reduced to 1 week. Much better.
If we continue the evolution we end up working on a single feature at a time and releasing it immediately. Each feature only takes a week to build, and preparation and release times are now down to 1/2 a week. At this point, we don’t really have a schedule anymore, but a natural workflow.
One of the things that strikes me about the diagrams above, is that each step in the evolution transforms them more into a smooth Cumulative Flow Diagram. In fact, in the same presentation, Mary showed the following picture taken from Building the Empire State. This is the building schedule from from around 1930, and itself looks remarkably like a CFD. Another example of how we are not inventing anything new, but can learn from other industries and successes.
Oct 6th
I ended up making notes at the Lean & Kanban UK Conference with good old fashioned pen an paper. Rather than try and write up those notes into something coherent and meaningful, I have decided to write them up in the style of a twitter stream. These are the things I would have tweeted if I’d been on my laptop. The quantity of “tweets” in no way represents the quality of the presentations. I also make no promises that all of the following “tweets” are actually <= 140 chars!
